MAUNA KEA RESORT

Workforce Housing Opportunity

Waikoloa Village – Lot 5-B-1 (Aloha Waikoloa)

Solving West Hawaiʻi’s Workforce Housing Challenge

Mauna Kea Resort and the broader Kohala Coast hospitality industry continue to face a persistent workforce housing constraint. The ability to attract and retain employees increasingly depends on access to high-quality, well-located rental housing within a reasonable commute.

Waikoloa Lot 5-B-1 (“Aloha Waikoloa”) represents one of the few fully entitled, construction-ready multifamily sites in West Hawaiʻi capable of delivering housing at meaningful scale within a defined and near-term timeline.

Strategic Location

Click on images to enlarge

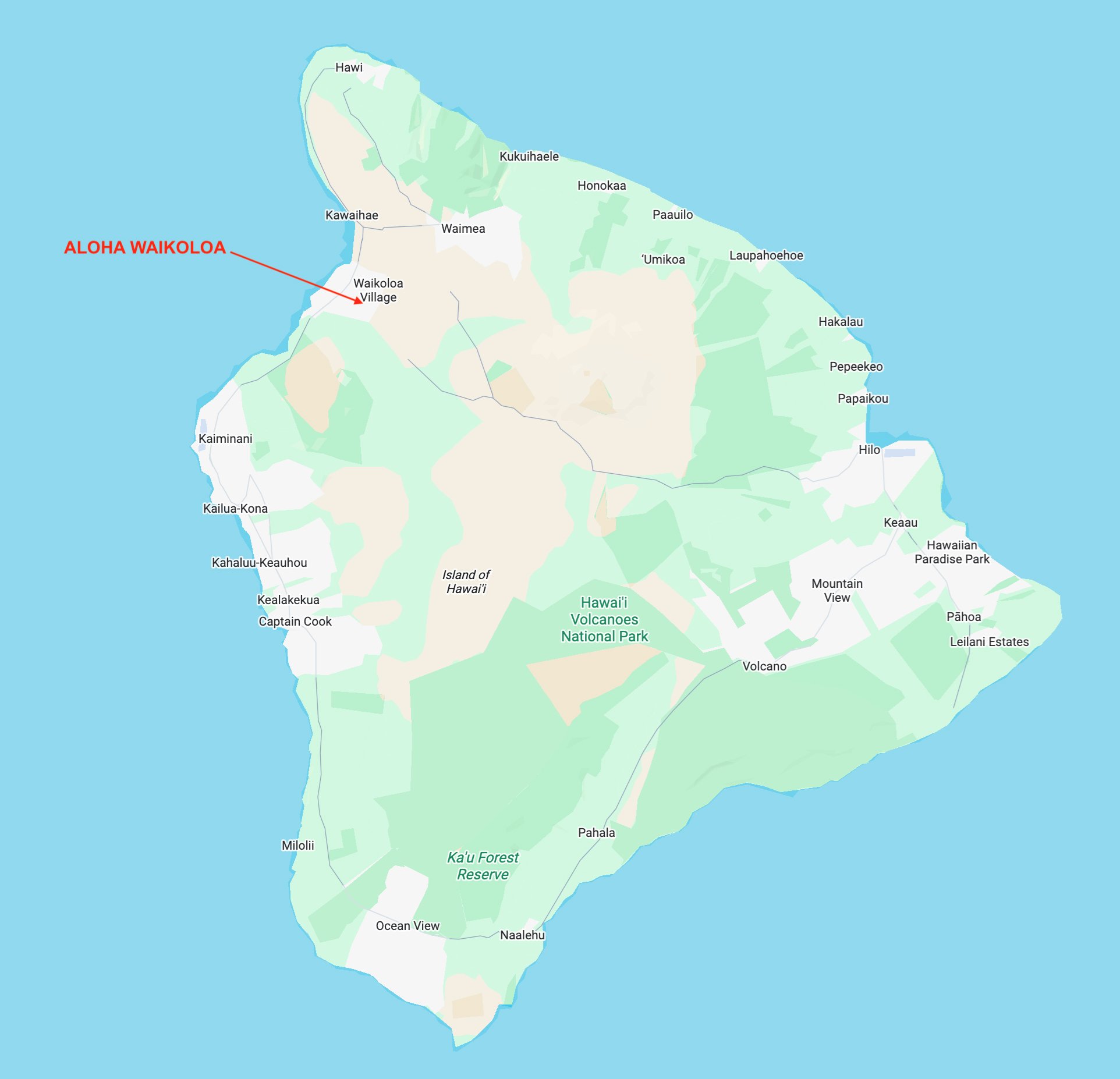

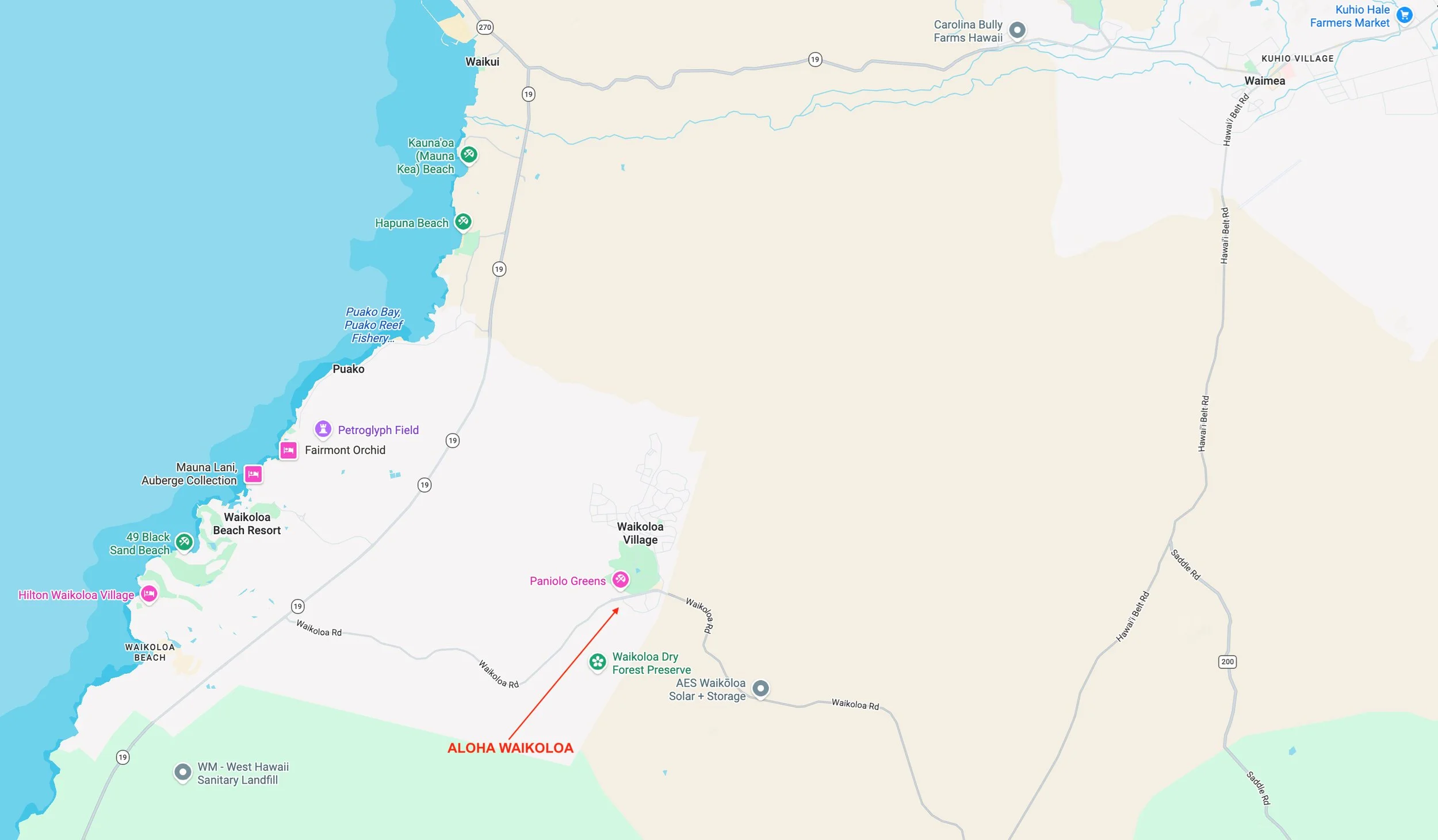

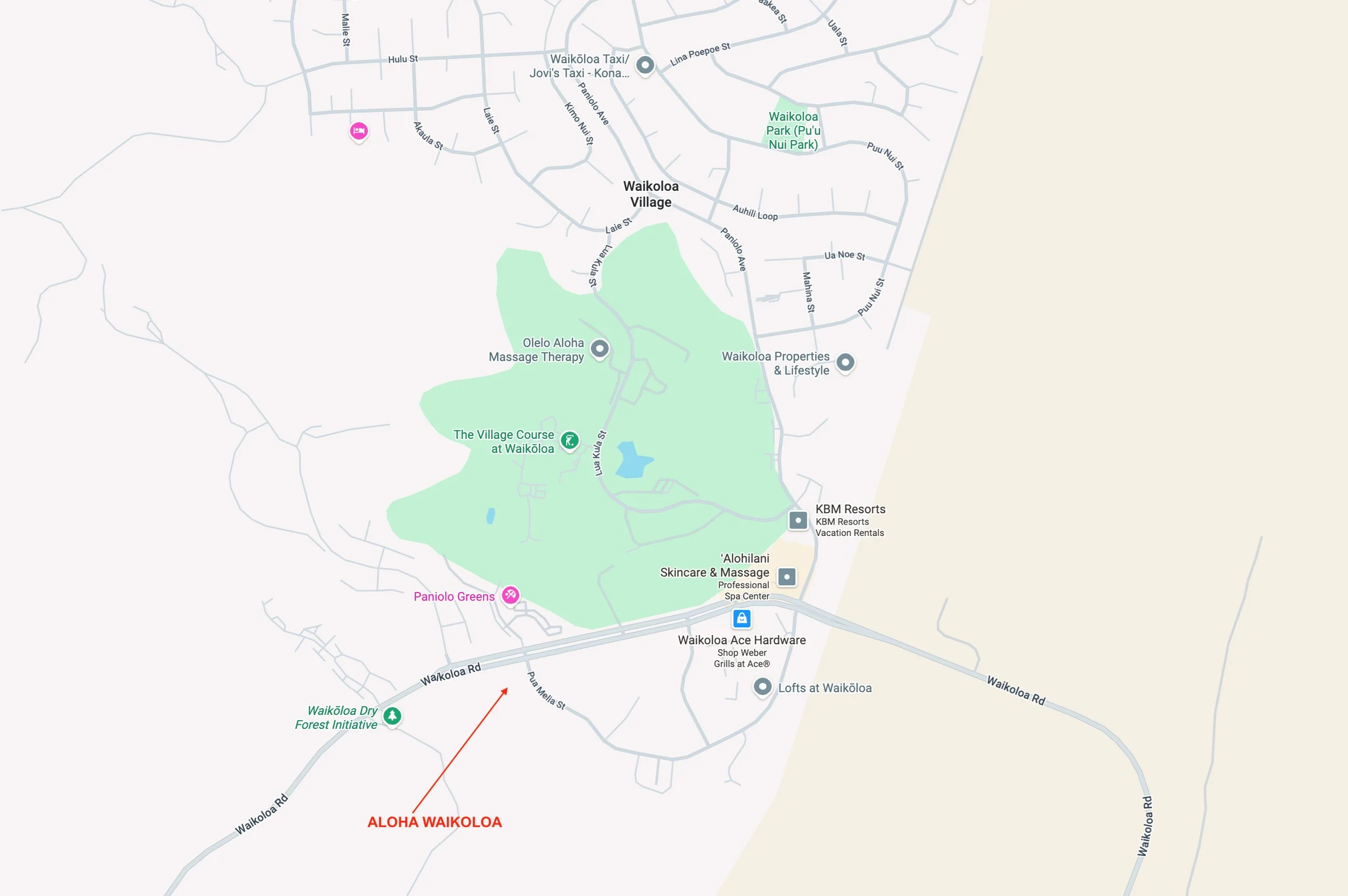

Lot 5-B-1 is centrally located in Waikoloa Village:

  • Approximately 15–20 minutes to Mauna Kea Resort

  • Adjacent to Waikoloa Plaza (Foodland, retail, services)

  • Walking distance to schools and community amenities

  • Immediately surrounded by additional new residential growth

Waikoloa Village has become the primary residential hub serving Kohala Coast employees.

Project Overview – Lot 5-B-1

  • Total Site Area: 15.47 acres

  • Zoning: RM-1.5 (Multi-Family Residential)

  • Total Entitlement: 329 apartment units

  • Configuration: 7 four-story residential buildings (47 units each)

  • Permitted Uses:

    • Long-term rentals

    • Extended-stay rentals (30+ days)

    • Short-term rentals (nightly), per zoning and CPR

A Condominium Property Regime (CPR) has been formed to create seven separately deeded building sites, allowing phased or multi-party development.

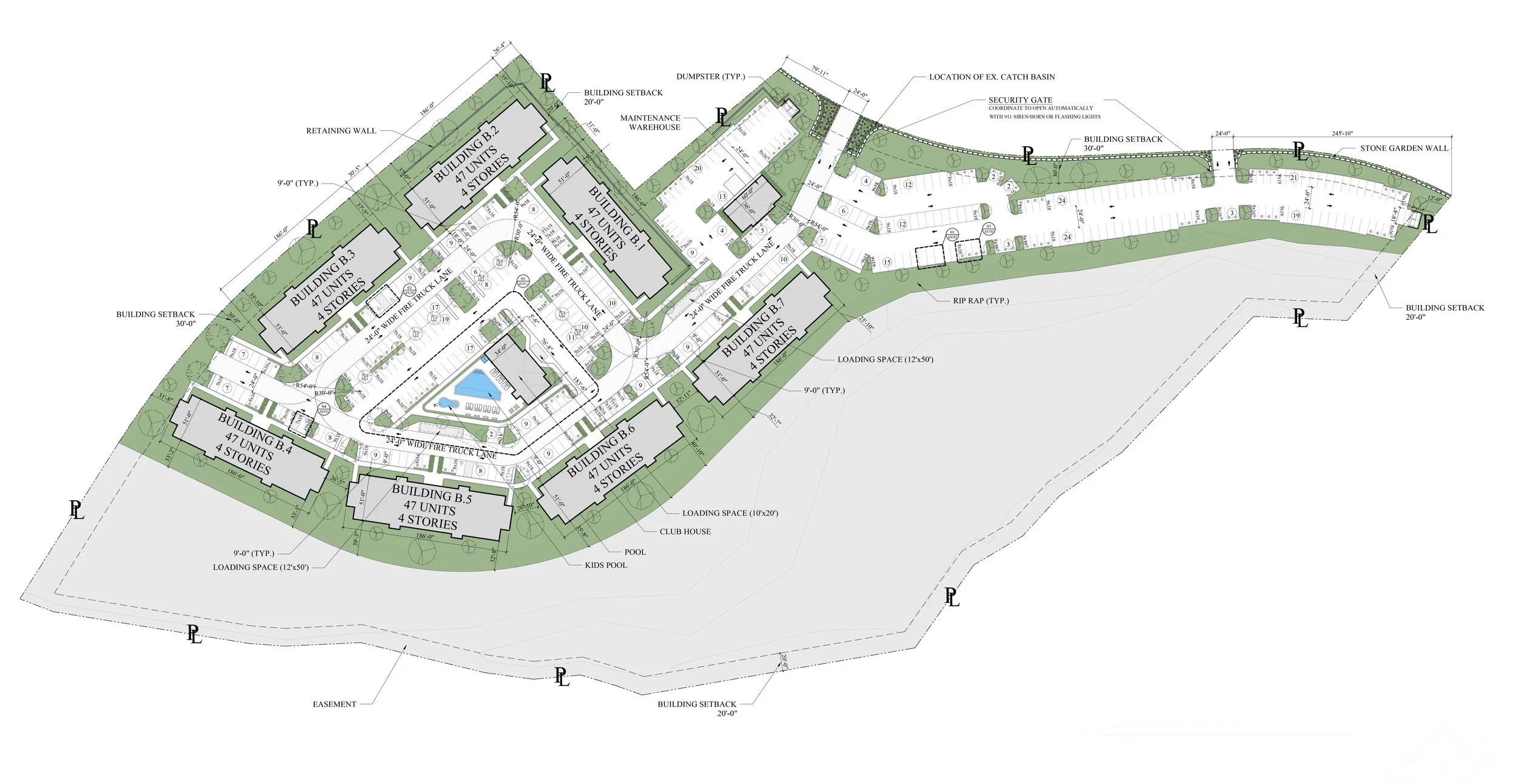

Site Plan

The approved site plan organizes the seven buildings around shared access roads, parking, and common area amenities.

Brown Development intends to construct two of the seven buildings directly, with the remaining pad sites available for acquisition by third parties.

All building owners will contribute their pro rata share of common area construction costs, including internal roads, parking areas, utilities, drainage, and shared site improvements.

An owners’ association will be formed under the CPR structure to provide long-term management, maintenance, and governance of the common areas, ensuring consistent standards and coordinated operations across the development.

CPR Structure

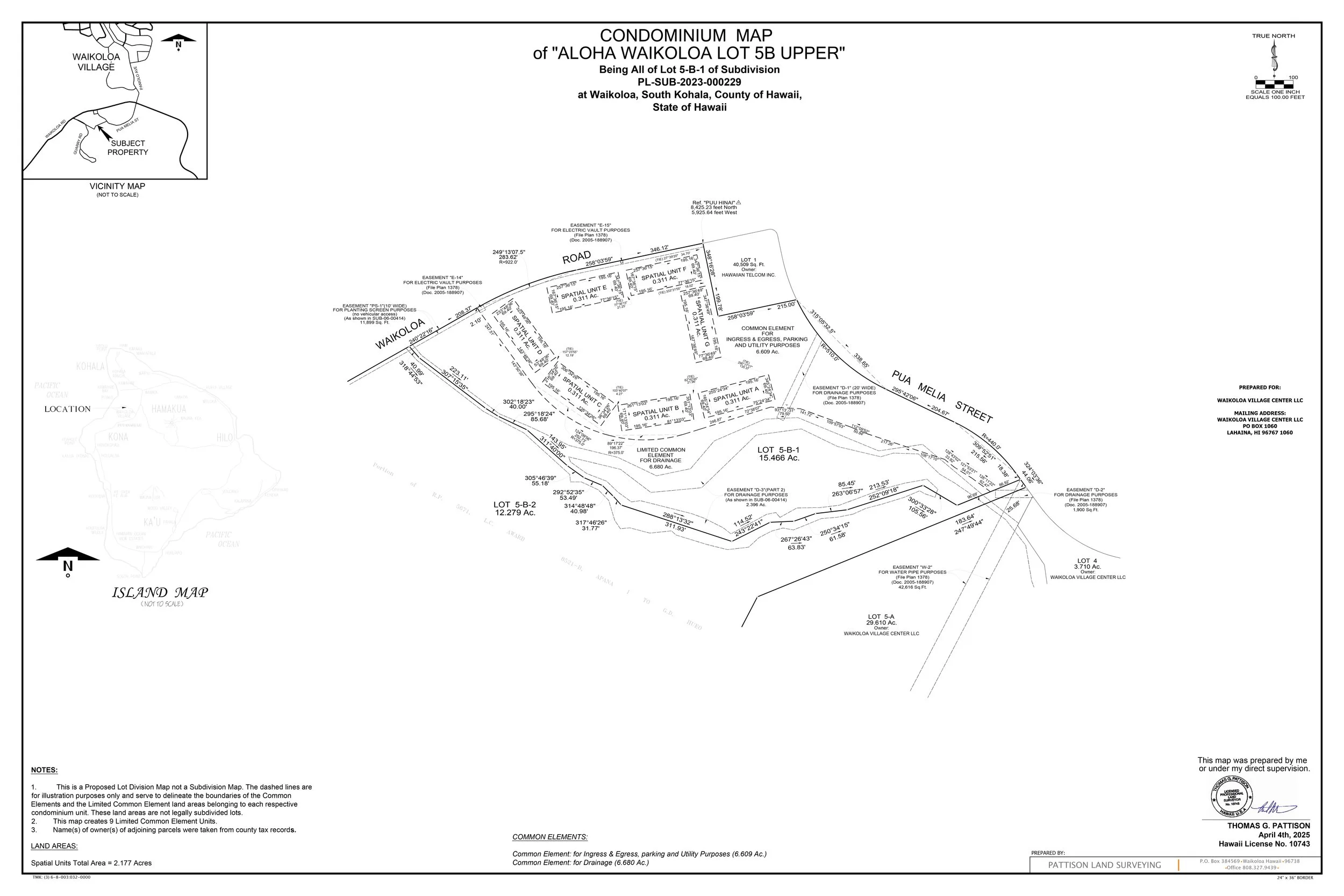

A Condominium Property Regime (CPR) has been recorded to create seven individually deeded development pads.

This structure allows for:

  • Acquisition of individual buildings

  • Phased development

  • Independent financing and ownership

  • Flexible capital structuring

Each pad site is fully entitled for one 47-unit residential building, while shared improvements are governed through the CPR and owners’ association framework.

Building Design

The approved apartment building design has already received County Final Plan Approval. The same building design is also approved on adjacent parcels, creating construction efficiency and design continuity.

Each building includes:

  • Four stories

  • Elevator-served interior corridors

  • Surface parking

  • Contemporary exterior finishes

  • Efficient, market-proven unit layouts

Unit Mix (Per Building – 47 Units)

Each building contains:

This mix supports a range of workforce housing needs, including:

  • Single employees

  • Roommate configurations

  • Small families

  • Supervisory and management-level staff

Efficient layouts maximize livability while maintaining cost discipline. Ceiling heights, natural light, and functional storage solutions support long-term residential comfort.

Permitting & Development Status

The project is fully entitled and advancing through final permitting.

Permit Summary

Approval / Submission

County of Hawaiʻi Final Plan Approval
Civil & Landscape Plans
County of Hawaiʻi Mass Grading Permit
State of Hawaiʻi NPDES Permit
Building Plans
Building Plans
Building Permit
Building Permit

Status

Approved
Approved
Approved
Approved
Completed
Submitted for Review
Submitted for Review
Approved

Date

February 2025
February 2025
March 2025
April 2025
September 2025
September 2025
September 2025
February 2026

Construction Timeline

  • Vertical Construction Start: As early as March 2027

  • Construction Duration: Approximately 12–18 months

  • Completion: 2028 (depending on phasing)

Because the site is fully entitled and CPR’ed, vertical construction can proceed without additional zoning or planning approvals.

Why Lot 5-B-1 Matters to Mauna Kea Resort

  • One of the few large-scale, shovel-ready multifamily sites in west Hawaii

  • Scalable across multiple buildings

  • Flexible ownership and delivery structure

  • Clear governance framework through CPR and owners’ association

  • Proven building design already approved

  • Adjacent to significant additional residential growth

  • Defined development timeline

This project provides a practical, near-term pathway to materially expand housing inventory within commuting distance of Mauna Kea Resort.

Next Steps

Brown Development welcomes the opportunity to meet with Mauna Kea Resort leadership to explore how Aloha Waikoloa at Lot 5-B-1 can support long-term workforce housing objectives.

Please contact:

Greg Brown
Brown Development LLC
greg@bdhawaii.com
(808) 283-8326
